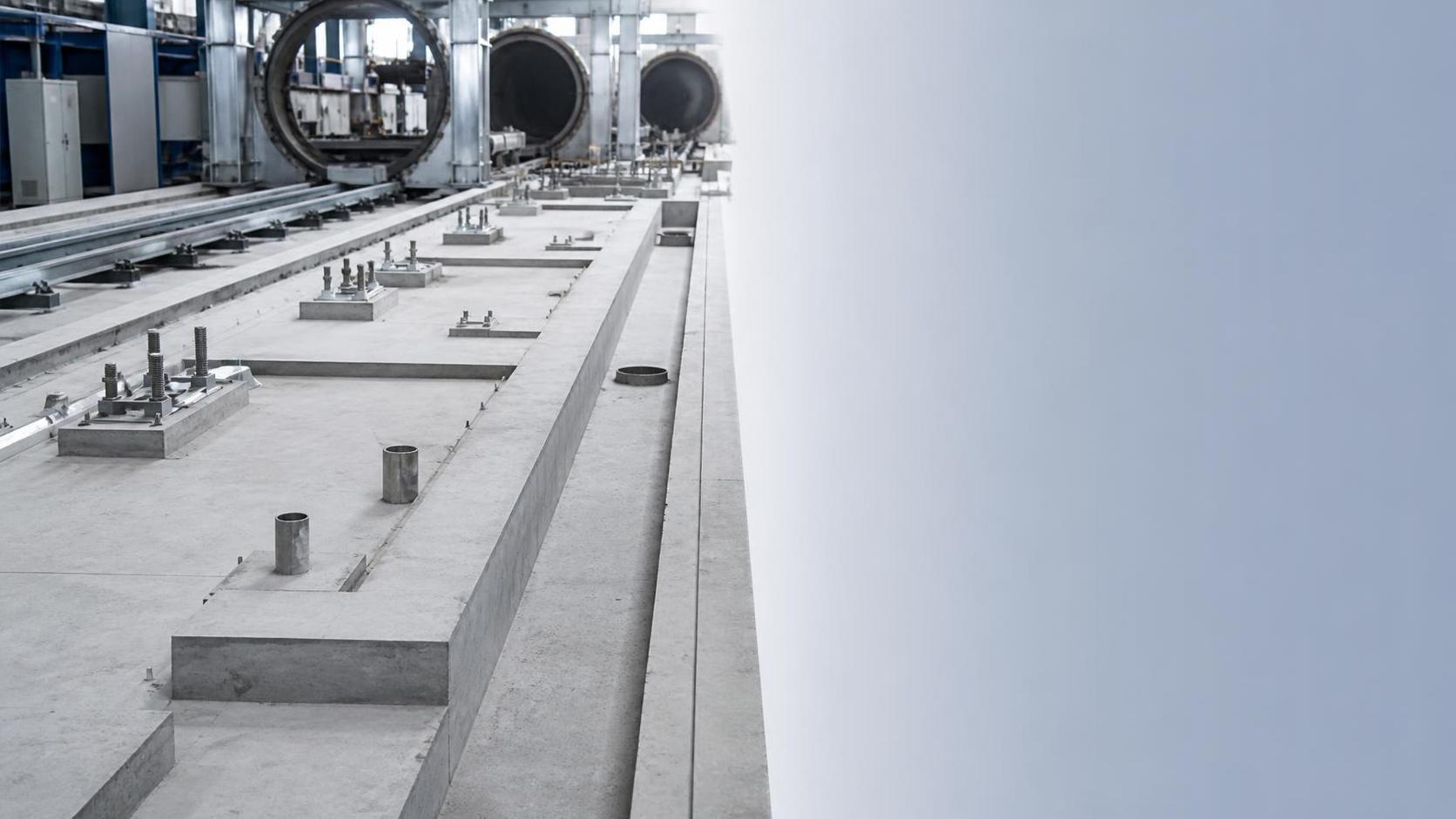

Does AAC Plant Installation Include Foundation Work?

Publish time:Aug 27, 2026
Reading:此处显示添加时间

Foundation work is often part of AAC plant installation, but it is not automatically included in every equipment supply scope. The answer depends on the contract boundary, local construction conditions, and the level of installation service agreed before shipment. Equipment delivery may cover machinery, installation guidance, mechanical assembly, and commissioning support, while excavation, reinforced concrete, drainage, embedded services, and building works may remain separate civil works.

For an AAC plant, this distinction matters because the production process combines large static equipment, moving machinery, elevated structures, heat-related systems, and wet-process areas. A foundation that is incorrectly located, insufficiently reinforced, or released before concrete has reached adequate strength can affect alignment, vibration behavior, rail travel, pipe routing, and later maintenance access. Foundation work should therefore be defined as an engineering package with clear interface points rather than treated as a minor preparatory task.

What “Foundation Work” Can Mean in an AAC Plant

The phrase can refer to several different activities. At its simplest, it may mean casting concrete pads beneath major machines. In a complete project context, it can also include site grading, geotechnical review, excavation, compacted sub-base preparation, reinforced concrete structures, drainage channels, trenches, embedded anchor bolts, curing, surveying, and acceptance measurements.

An AAC production facility normally requires foundations of different forms because its equipment does not impose one uniform load condition. A raw material receiving area may need a hard-wearing slab designed for vehicle movement and wet material handling. Grinding equipment may require a more rigid machine base. Mixing and casting equipment may need accurately positioned supports, embedded plates, service pits, and washdown drainage. Cutting lines demand precise rail and frame alignment. Autoclave areas involve heavy pressure vessels, pipe supports, condensate management, and space for safe access around valves and doors.

Foundation work may also include the supporting structural interfaces around the equipment. These can include columns for platforms, steelwork bearing points, cable trench crossings, tank supports, slurry pits, maintenance walkways, and elevated pipe racks. Whether these elements belong to “installation” depends on the scope document. A short phrase such as “installation included” is not sufficiently precise unless it identifies the civil, mechanical, electrical, and commissioning boundaries.

Equipment Installation and Civil Construction Are Different Scopes

Mechanical installation usually begins after the civil works have been inspected and accepted. It covers setting machinery onto prepared bases, leveling frames, installing fasteners, assembling conveyors, connecting drives, fitting piping, mounting guards, and verifying motion. Civil construction creates the physical conditions that allow this work to proceed. Mixing those responsibilities without a detailed interface schedule commonly creates delays.

Project Activity Typical Civil Scope Typical Equipment Installation Scope
Site preparation Earthwork, grading, compaction, access roads, stormwater control May provide equipment layout data and loading information
Machine bases Excavation, formwork, reinforcement, concrete placement, curing Anchor-bolt templates, base dimensions, elevation requirements
Equipment setting Approved and accessible foundation surface Positioning, leveling, grouting, mechanical fastening
Underground services Trenches, sleeves, drainage pits, buried pipes where specified Connection points and required process interfaces
Startup preparation Finished floors, drainage, structural access, building readiness Dry-run inspection, calibration, interlock tests, process commissioning

The split shown above is typical rather than universal. A turnkey arrangement may combine both categories under one project schedule. In other arrangements, drawings and technical instructions are supplied for foundations, while a local civil contractor performs the work. There can also be a hybrid arrangement in which the equipment side prepares the foundation design inputs and provides site supervision, but does not supply labor or construction materials for the concrete works.

Why AAC Foundations Require More Than a Flat Concrete Floor

A level floor alone does not establish a usable equipment foundation. Each major machine must be supported at the correct elevation and coordinate, with sufficient bearing capacity and stiffness for its operating condition. Reinforced concrete bases are often designed around dead load, operating load, dynamic load, thermal movement, service access, and the actual soil condition below the structure.

For example, a ball mill or comparable grinding assembly may create cyclical forces that need to be considered in the base design. A mixer and casting system can involve wet slurry, cleaning water, and frequent movement near the machine, making drainage slope and surface finish relevant. A cutting section depends on stable longitudinal alignment; uneven settlement can cause travel issues, inaccurate cuts, excessive wear, or interference between moving components. Autoclave supports must follow the vessel arrangement and associated piping loads rather than being placed from a generic building grid alone.

Foundation drawings should identify the following items with enough detail for construction and inspection:

  • Equipment centerlines, reference elevations, and dimensional tolerances tied to one common plant datum.
  • Base outlines, pedestal locations, reinforced sections, concrete grade requirements, and any non-shrink grout zones.
  • Anchor-bolt size, spacing, projection, thread protection, and template arrangement before the concrete pour.
  • Embedded plates, sleeves, conduits, trenches, drainage openings, and exclusions needed for piping or cable routes.
  • Required clearances around doors, platforms, chain drives, control cabinets, lifting points, and maintenance zones.

These details should be coordinated before formwork is installed. Drilling a few corrective holes after a pour may be possible in limited situations, but it is not an acceptable substitute for confirming the machine interface in advance. Unplanned drilling can damage reinforcement, reduce edge distance, introduce cracks, or conflict with load-bearing anchor locations.

Layout Control Starts Before Concrete Is Poured

AAC equipment is sequential. Raw materials are prepared, dosed, mixed, cast, pre-cured, cut, autoclaved, and handled through linked stations. A local correction at one foundation can move a conveyor transfer point, reduce clearance beside a mold circulation route, or shift the location of a valve platform. The effect may become visible only during assembly, when correcting it is slower and more expensive.

A workable layout review normally compares the equipment general arrangement with the building column grid, site boundaries, drainage level, crane coverage, door openings, and utility entries. It should also review the route used to unload and move large components into position. Some elements can be installed only before adjacent structures, roof members, or piping are completed. If an autoclave body, long cutting frame, or large tank has restricted access after the building is enclosed, the installation sequence must be reflected in the civil schedule.

Survey control should use durable benchmarks located outside areas likely to be disturbed by excavation or vehicle traffic. Elevations should be checked again after formwork installation and before concrete placement. Once concrete has cured, actual anchor positions and top-of-foundation levels should be measured and compared with the approved equipment drawings. This record provides a clean handover point between civil works and mechanical installation.

Common Scope Gaps That Cause Delays

The most frequent misunderstanding is assuming that a supplier’s foundation drawing means that foundation construction is included. A drawing may only communicate dimensions and loads. It does not necessarily include excavation machinery, rebar, concrete, waterproofing, survey labor, local permits, utility connection, or construction supervision. The commercial agreement must state which party supplies each item.

Another common issue is treating all foundations as identical slabs. Different equipment positions may need pits, raised plinths, isolated bases, embedded rails, or openings for slurry return and drainage. A floor slope that appears reasonable for general cleaning can become problematic if it changes the elevation of a precision cutting rail or prevents a machine base from sitting uniformly.

Anchor bolts deserve particular attention. Their position, verticality, and exposed length affect whether the equipment can be set without forcing or slotting base holes. Bolts should not be improvised from locally available bar stock unless the approved design permits it. Proper templates keep groups of bolts in position during pouring, and thread protection prevents damage from concrete splashes or construction traffic.

Concrete maturity is another scheduling issue. Equipment should not be loaded onto a base merely because the surface appears dry. The project engineer or responsible civil party should confirm that the concrete has reached the required condition before machinery setting, grouting, and tightening begin. Premature loading can lead to cracking, settlement, or loss of alignment.

Comparing Three Installation Arrangements

A supply-only arrangement gives the clearest separation of responsibility, but it requires strong local coordination. Equipment documents typically provide foundation loads, dimensions, and interface requirements. Civil construction is arranged separately, and mechanical installation begins after site acceptance. This approach can work well where local engineering resources are already established, though drawing interpretation and revision control need close attention.

Under an installation-guidance arrangement, the equipment side may send technical personnel to inspect foundations, guide assembly, and support commissioning. The concrete work still remains a local construction scope. The advantage is direct communication between the machine design and on-site assembly process. However, site readiness must be carefully scheduled because installation personnel cannot efficiently proceed while civil corrections are still underway.

A broader engineering, procurement, and installation arrangement can place more activities under one coordinated schedule. It may reduce uncertainty at discipline interfaces, particularly for complex plants with substantial piping, automation, and structural work. Even then, exclusions must be identified: land preparation, building permits, grid power, water sources, fuel facilities, and environmental infrastructure may have separate local obligations depending on the agreement and location.

None of these arrangements is inherently better in every situation. The practical comparison is whether the responsibility for design input, construction execution, inspection, and final acceptance is traceable for every foundation and utility interface.

Information Needed Before the Scope Can Be Confirmed

A reliable answer to “Does AAC plant installation include foundation work?” requires project-specific information. The equipment arrangement, production capacity, soil data, building concept, utility plan, and regional construction conditions all influence the foundation package. A preliminary proposal may show approximate footprint requirements, but final civil design should be based on approved equipment drawings and a qualified assessment of the site.

The required inputs generally include topographic information, soil investigation results where applicable, local seismic and wind design conditions, frost depth where relevant, groundwater conditions, plant layout, equipment loads, and intended process utilities. Floor finish requirements should also be agreed early. Areas exposed to slurry, lime, condensate, wash water, or repeated forklift traffic may require different detailing from dry electrical or finished-product areas.

Electrical and piping interfaces should be reviewed alongside the foundations. Cable trenches placed too close to heavy machine bases can obstruct anchor locations or create difficult maintenance conditions. Drain pits must be accessible for cleaning and should not sit where they interfere with moving equipment. Service sleeves should be sized and positioned according to the actual routing plan, with spare capacity considered only where it does not weaken the structure or create uncontrolled openings.

Foundation Acceptance Before Mechanical Work

Before equipment is unloaded onto prepared bases, the site should confirm that the layout references are available, the concrete is accepted, anchor bolts are clean, and access routes can support transport and lifting activities. Foundation surfaces should be free of loose material, standing water, protrusions, and unapproved repairs. Where grout is required, the bearing surface and equipment base should be prepared according to the grout material requirements.

Mechanical crews then verify base elevations, centerline positions, diagonal dimensions where relevant, bolt patterns, and clearances. Machinery is set, leveled, and secured in the prescribed sequence. Grouting is commonly completed after final positioning but before full operating loads are applied. Alignment should be rechecked after grouting and after connecting adjacent conveyors, rails, pipes, or drives, since connected systems can introduce stress if their supports are not coordinated.

Foundation work therefore belongs to AAC plant installation in an engineering sense even when it is excluded from the equipment contract in a commercial sense. Treating civil works, machine installation, and commissioning as linked stages preserves the tolerances that the production line requires. The clearest project documents identify the exact foundation scope, issued drawing revision, acceptance criteria, site responsibilities, and handover milestone before construction begins.
